2019 年授牌升级SEZ(国家经济特区);提供“3小时”投资批复服务,缩短建厂周期以及一站式企业设立手续,包括协助获得必要的许可证、设立公司、雇佣劳动力,24/7保安和维修服务。
Upgraded to SEZ (National Special Economic Zone) in 2019; provides a '3-hours' investment approval service, shortening factory construction cycles and offering one-stop company establishment procedures, including assistance with obtaining necessary permits, company setup, workforce hiring, and 24/7 security and maintenance services.
半径 200km 覆盖1.2 亿人口本地市场 。所毗邻三宝垄(Semarang),印尼第四大城市,位于中爪哇,获称“印尼东莞”。华人约为20万到25万之间,占当地总人口的15%左右。
Within a 200 km radius, the local market covers 120 million people. It is adjacent to Semarang, Indonesia’s fourth-largest city, located in Central Java and nicknamed the 'Dong Guan of Indonesia.' The Chinese community numbers approximately 200,000 to 250,000, accounting for around 15% of the local population.

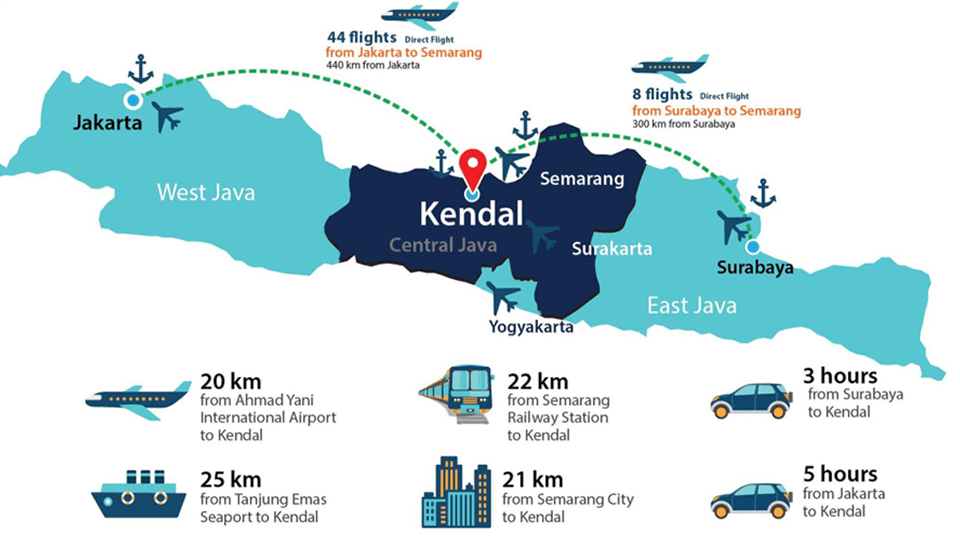

距三宝垄市区21km,距离雅加达5小时陆运;空港条件,距三宝垄国际机场20km;
深港条件,距离现有深水港口25km;2025年15万吨级深水港将投产,预计2026年建成。
Located 21 km from Semarang city center and 5 hours by land from Jakarta;Airport access: 20 km from Semarang International Airport;Deep-water port access: 25 km from the existing deep-water port; a 150,000-ton deep-water port is scheduled to commence operations in 2025, expected to be completed in 2026.
所得税豁免最长20年;进口设备、原材料关税全免,增值税豁免土地交易,所得税优惠、所得税津贴、商品运达无增值税、某些战略进口免增值税。
Income tax exemption for up to 20 years; full exemption of import duties on equipment and raw materials; VAT exemption on land transactions; income tax incentives and allowances; VAT-free delivery of goods; and VAT exemption on certain strategic imports.
一期售价100$/㎡,有产权证,使用权70年,售罄;

二期1200Ha供地,聚焦新能源汽车、数据中心、高端消费品制造三大领域。
Phase 1 priced at $100/㎡, with property certificate and 70-year land use rights, fully sold out;Phase 2 offers 1,200 ha of land, focusing on three main sectors: new energy vehicles, data centers, and high-end consumer goods manufacturing.
入驻企业达124家,大陆投资者占比位居达41%。
A total of 124 enterprises have settled in, with Chinese investors accounting for 41%.
鱼塘填埋而成,地质承载力较差,地坪需要5-6年完成沉降;
桩长常大于40m,造成成本上浮;
本地劳务、建材资源较为丰富,该部分成本相对较低。
Formed by filling fish ponds, the site has poor geological bearing capacity, requiring 5–6 years for ground settlement; piles often exceed 40 m in length, increasing costs; local labor and construction materials are relatively abundant, making this portion of the cost relatively low.
